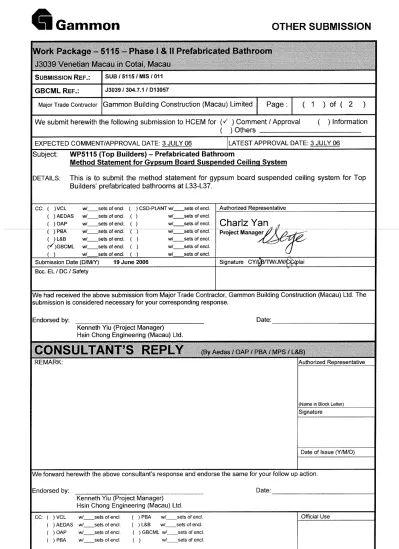

(1)
(2)
(3)

TOP BUILDERS

INTERNATIONAL CO. LTD.

得寶國際有限公司

Method Statement

For

Gypsum Board

Suspended Ceiling System

Project: Venetian Macau in Cotal, Macau

Re: Work Package 5115 (Top Builders), Prefabricated Bathroom

Revision: B

(4)

Method Statement for

Gypsum Board Suspended Ceiling System

Page 2 of 5

Table of Content

Content

…………..

2

Introduction

…………..

3

Relevant

submission

…………..

3

Installation

of

suspended

ceiling

system

…………..

3

-

4

Preparation

work

…………..

3

Concerns

…………..

3

Ceiling

Installation …………..

4

Cornice

Installation

…………...

4

-

5

(5)

Method Statement for

Gypsum Board Suspended Ceiling System

Page 3 of 5

Scope of work

Trade contractor of this project will be responsible for the execution of the work in

accordance with the specifications and relevant approved documentations. The

scope of work includes supply and installation of proposed gypsum board

suspended ceiling system including proprietary KIRII SD-19 (Standard) System

with W-Bar, C-38 Channel, Hanger, W-Clip, Z-Bracket and Bolt and moisture

resistant board (MR - GypBoard

TM

) at the L33 to L37 tower suite bathroom areas.

Relevant submission

• Material Submission of the KIRII SD-19 (Standard) System including

samples and catalogue.

• Material

Submission of the GypBoard

TM

including samples and catalogue.

Installation of suspended ceiling system

• Preparation work

1. Site Cleaning

2. Site surveying and setting out

3. Erect working platform if necessary and according site safety

regulations.

• Concerns

1. Checking Ceiling Level

Before installation work starts, check and ensure at least 4-in.

minimum clearance for installing ceiling panels.

2. Working at Height

Working platform will be provided if higher than 2m and erected by

experience competent worker and inspected by the appointed

professional person signing and certifying Form 4 & 5 before use and

re-inspection within 14 days.

3. Obstruction

When hanging the main tees, if the hanger wire holes are not

accessible, due to duct work, lighting, or other site works, using the

convenience holes for the hanger wire.

z Ceiling Installation

1. Mark the ceiling height on the surrounding walls according to the

reference line given by the Main Contractor.

(6)

Method Statement for

Gypsum Board Suspended Ceiling System

Page 4 of 5

2. Mark carrying channel (C-38 channel) by stretch a string across the

room at ceiling height.

3. Installation of the 8mm diameter threaded suspension, fixed by using

Z-Bracket to the ceiling slab. Spacing of suspension both must be at

1200m max. in either direction and at perimeter of ceiling as required.

4. The C-38 channel must be placed at 1200mm Max. shall be hung to

the lower part of the suspension bolts by means of galvanized steel

hangers and nuts.

5. The W-Bar at a spacing of 400mm Max. shall be fixed to the C-38

channel with W-Clips at each intersection. W-Clips must as a rule

alternate with the sides of the carrying channel.

6. Rigid and aligned system for the fixing of ceiling board must be

provided with separated pieces of C-38 channel and W-Bar to be

jointed by channel joint and double joint respectively.

7. Extra hangers to be provided where opening are required for light

fittings and access panels.

8. All components must be well fixed and the suspension system must

be correctly aligned and accurately leveled before attaching the

ceiling board.

9. The gypsum board shall be fixed by screws at 300m Max. to the

W-Bar with long edges of the gypsum board placed parallel to the

W-Bar.

10. Finish of all joints and screw heads with joint tape and joint compound

must be in accordance with manufacturer's instruction which shall be

approved by the Architect’s consultant.

11. Primer and Painting works can be proceeded after completion of

gypsum board installation.

12. Details of Step 10 and 11, please refer to the Method Statement for

Painting.

z Cornice Installation

1. Before commence the installation, ensure the wall and ceiling surface

is sound and free from any material i.e. wallpaper, loose or flaking

paint or plaster within the operation area.

(7)

Method Statement for

Gypsum Board Suspended Ceiling System

Page 5 of 5

3. Measure the cornice length required and mark wall edge of moulding

before screw fixing. Leave enough moulding length beyond the wall

edge mark to allow for external mitre cuts.

4. As cutting the mitre in the corner angle, the mitres must be marked out

and cut for each individual corner.

5. After cutting the cornice to be proper size, screw casting to wall and

ceiling.

6. Fill, joints and screw holes first Herculite Fibrefix. Once the Fibrefix

has set finish off the joints and screw holes with plaster, allow to dry

and sand smooth.

(8)

Review No. B Date: 16-06-02006

HAZARD IDENTICATION SHEET

Page 1 of 3

Project: Venetia Cotai, Macau – Prefabricated Bathroom Work Package Code: WP 5115 (Top Builders)

Subject: Gypsum board Suspended Ceiling System Analysis by: Edward Leung

Location: Hotel Tower

Item Job Task Hazard People

Affected Cause of Hazard

Worst Harm Due to Hazard

Existing Control Measures Remark

1 General works Personal injury worker and affected people nearby

- Lack of site safety knowledge

- Inappropriate use of PPE

Severely injured

- Worker should attend Safety Induction Training provided by GAMMON. - Provided appropriate PPE as job

required.

- Keep minimum stock of PPE to be maintained for issuing.

2 Drilling eye injury Noise nuisance Body Injury worker and affected people nearby

- Defective electric tools being used.

- Worker did not wear and use PPE - No Warning sign

Fatality - No patent defect on the electric tools to be used.

- Appropriate electric tools shall be selected.

- Monthly inspection of the tools by registered electrician.

- Fence off the working areas to prevent unauthorized entry.

- Ensure the workers Wear long sleeve Protective cloths & safety boot - Safety gloves & eye protector.

3 Manual handling and transporting of material Twisted , slipping, tripping, hit by objects Muscle strain During manual handling

workers - Using improper lifting method to handle goods

- poor housekeeping - Worker did not wear

and use PPE

Severely injured

- Provide pre-work body exercise to minimize the risk of injury

- Wear long sleeve safety shoes to protect the ankle and foot. - Use the mechanical equipment if

possible.

- Always keep the workplace dry and tidy.

(9)

Review No. B Date: 16-06-02006

HAZARD IDENTICATION SHEET

Page 2 of 3

Item Job Task Hazard People

Affected Cause of Hazard

Worst Harm Due to Hazard

Existing Control Measures Remark

4 Materials storage Fire worker and affected people nearby - Poor Housekeeping - Smoking at the

workplace and storage yards.

- Insufficient Ventilation

Fatality - Flammable materials and goods must be kept away from the workplace.

- Provide fire extinguishers at the workplace and storage yards.

- Clean all the rubbish, paper, scraps all the time.

- Display “no smoking’ signage and no smoking is allowed at the workplace. - Adequate ventilation

5 Ceiling

Installation

Collapse of

working platform worker and affected people nearby - Platform erected by non-experience competent workers.

Serious injury - Appointed Registered professional inspect and sign for the workability of working platform of height above 1.8m.

6 Ceiling

installation

Fall of person at

height worker - Inadequate platform being used by workers. - Workers did not wear

and use PPE.

Fatality - 200mm high toe-board and fence at 450mm and 900mm to be installed. - Prohibit to move the working platform if

(10)

Review No. B Date: 16-06-02006

HAZARD IDENTICATION SHEET

Page 3 of 3

Item Job Task Hazard People

Affected Cause of Hazard

Worst Harm Due to Hazard

Existing Control Measures Remark

7 Ceiling

installation

Falling objects from the working platform

Worker and affected people nearby

- Worker working under the working platform. - No Warning sign

Severely injured

- Working platform should be closely planked with 200mm toe-board equipped.

- No other works shall be carried out under the activities that are working above.

- Chain block shall be used to the materials that are heavy in weight and large in size.

- Fence off the working area with barrier and notice / warning sign should be provided.

(11)

Review No. B Date: 16-06-2006

RISK ASSESSMENT SHEET

Page 1 of 3

Note: Probability or Likelihood Rating: Almost Certain ( 5 ) Probable ( 4 ) Possible ( 3 ) Remote (2 ) Impossible (1) Consequence Rating: Very High ( 5 ) High ( 4 ) Medium ( 3 ) Low ( 2 ) Very Low ( 1)

Risk Level: ( RED ) ( ORANGE ) ( YELLOW ) (GREEN)

Works Related Projects/Department: Venetia Cotai, Macau Works Related Projects/Department Code: WP 5115 (Top Builders)

Type of Activity Operation: Prefabricated Bathroom Analysis by: Edward Leung

Location: Hotel Tower

Rating of Harm

Item Risk Existing Control Measures

Probability1 Consequences2

Risk

Level3 Recommended Action Remark

1 Personal injury - Worker should attend Safety Induction Training provided by GAMMON. - Provided appropriate PPE as job

required.

- Keep minimum stock of PPE to be maintained for issuing.

3 1 3

(Green)

Safety Induction Training, Specific PPE required

2 eye injury

Noise nuisance Body Injury

- No patent defect on the electric tools to be used.

- Appropriate electric tools shall be selected.

- Monthly inspection of the tools by registered electrician.

- Fence off the working areas to prevent unauthorized entry.

- Ensure the workers Wear long sleeve Protective cloths & safety boot - Safety gloves & eye protector.

2 3 6

(Green)

Specific PPE required Training required 3 Twisted , slipping, tripping, hit by objects Muscle strain During manual handling

- Provide pre-work body exercise to minimize the risk of injury

- Wear long sleeve safety shoes to protect the ankle and foot. - Use the mechanical equipment if

possible.

- Always keep the workplace dry and tidy.

2 2 4

(Green)

(12)

Review No. B Date: 16-06-2006

RISK ASSESSMENT SHEET

Page 2 of 3

Note: Probability or Likelihood Rating: Almost Certain ( 5 ) Probable ( 4 ) Possible ( 3 ) Remote (2 ) Impossible (1) Consequence Rating: Very High ( 5 ) High ( 4 ) Medium ( 3 ) Low ( 2 ) Very Low ( 1)

Risk Level: ( RED ) ( ORANGE ) ( YELLOW ) (GREEN)

Rating of Harm

Item Risk Existing Control Measures

Probability1 Consequences2

Risk

Level3 Recommended Action Remark

4 Fire - Flammable materials and goods must be

kept away from the workplace. - Provide fire extinguishers at the

workplace and storage yards.

- Clean all the rubbish, paper, scraps all the time.

- Display “no smoking’ signage and no smoking is allowed at the workplace. - Adequate ventilation

1 5 5

(Green)

Fire equipments Training, Specific Training

5 Collapse of

working platform

- Appointed Registered professional inspect and sign for the workability of working platform of height above 1.8m.

3 3 9

(Yellow)

Specific Training

6 Fall of person

at height

- 200mm high toe-board and fence at 450mm and 900mm to be installed. - Prohibit to move the working platform if

any worker on it.

2 4 8

(Yellow)

Specific Training & Safety Harness required

(13)

Review No. B Date: 16-06-2006

RISK ASSESSMENT SHEET

Page 3 of 3

Note: Probability or Likelihood Rating: Almost Certain ( 5 ) Probable ( 4 ) Possible ( 3 ) Remote (2 ) Impossible (1) Consequence Rating: Very High ( 5 ) High ( 4 ) Medium ( 3 ) Low ( 2 ) Very Low ( 1)

Risk Level: ( RED ) ( ORANGE ) ( YELLOW ) (GREEN)

Rating of Harm

Item Risk Existing Control Measures

Probability1 Consequences2

Risk

Level3 Recommended Action Remark

7 Falling objects

from the working platform

- Working platform should be closely planked with 200mm toe-board equipped.

- No other works shall be carried out under the activities that are working above.

Chain block shall be used to the materials that are heavy in weight and large in size.

Fence off the working area with barrier and notice / warning sign should be provided.

4 2 8

(Yellow)

Specific Training & Safety Harness required

References

Related documents
