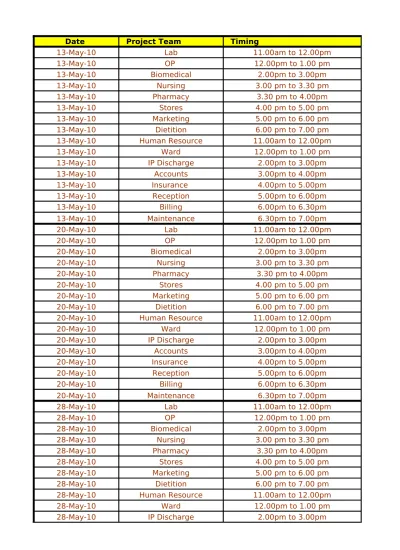

Date Project Team Timing
13-May-10 Lab 11.00am to 12.00pm
13-May-10 OP 12.00pm to 1.00 pm 13-May-10 Biomedical 2.00pm to 3.00pm 13-May-10 Nursing 3.00 pm to 3.30 pm 13-May-10 Pharmacy 3.30 pm to 4.00pm 13-May-10 Stores 4.00 pm to 5.00 pm 13-May-10 Marketing 5.00 pm to 6.00 pm 13-May-10 Dietition 6.00 pm to 7.00 pm
13-May-10 Human Resource 11.00am to 12.00pm
13-May-10 Ward 12.00pm to 1.00 pm 13-May-10 IP Discharge 2.00pm to 3.00pm 13-May-10 Accounts 3.00pm to 4.00pm 13-May-10 Insurance 4.00pm to 5.00pm 13-May-10 Reception 5.00pm to 6.00pm 13-May-10 Billing 6.00pm to 6.30pm 13-May-10 Maintenance 6.30pm to 7.00pm
20-May-10 Lab 11.00am to 12.00pm
20-May-10 OP 12.00pm to 1.00 pm 20-May-10 Biomedical 2.00pm to 3.00pm 20-May-10 Nursing 3.00 pm to 3.30 pm 20-May-10 Pharmacy 3.30 pm to 4.00pm 20-May-10 Stores 4.00 pm to 5.00 pm 20-May-10 Marketing 5.00 pm to 6.00 pm 20-May-10 Dietition 6.00 pm to 7.00 pm
20-May-10 Human Resource 11.00am to 12.00pm
20-May-10 Ward 12.00pm to 1.00 pm 20-May-10 IP Discharge 2.00pm to 3.00pm 20-May-10 Accounts 3.00pm to 4.00pm 20-May-10 Insurance 4.00pm to 5.00pm 20-May-10 Reception 5.00pm to 6.00pm 20-May-10 Billing 6.00pm to 6.30pm 20-May-10 Maintenance 6.30pm to 7.00pm
28-May-10 Lab 11.00am to 12.00pm
28-May-10 OP 12.00pm to 1.00 pm 28-May-10 Biomedical 2.00pm to 3.00pm 28-May-10 Nursing 3.00 pm to 3.30 pm 28-May-10 Pharmacy 3.30 pm to 4.00pm 28-May-10 Stores 4.00 pm to 5.00 pm 28-May-10 Marketing 5.00 pm to 6.00 pm 28-May-10 Dietition 6.00 pm to 7.00 pm
28-May-10 Human Resource 11.00am to 12.00pm
28-May-10 Ward 12.00pm to 1.00 pm
28-May-10 Accounts 3.00pm to 4.00pm
28-May-10 Insurance 4.00pm to 5.00pm
28-May-10 Reception 5.00pm to 6.00pm
28-May-10 Billing 6.00pm to 6.30pm
Conusultant Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Rajarajan Rajarajan Rajarajan Rajarajan Rajarajan Rajarajan Rajarajan Rajarajan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Rajarajan Rajarajan Rajarajan Rajarajan Rajarajan Rajarajan Rajarajan Rajarajan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Jayabalan Rajarajan Rajarajan Rajarajan
Rajarajan Rajarajan Rajarajan Rajarajan Rajarajan
Project Team Lab OP Biomedical Nursing 13-May-10 Pharmacy Stores Marketing Dietition Human Resource Ward 13-May-10 IP Discharge 8-May-10 Accounts Insurance 8-May-10 Reception 8-May-10 Billing Maintenance
Note: Nurse and Ward team can take process improvement project . Define -
Measure Phase Measure - Analyse Phase Improve PhaseAnalyse - 08-May-10,
13-May-10
20-May-10, 28-May-10
08-May-10,
13-May-10 20-May-10, 28-May-10 08-May-10,
13-May-10 20-May-10, 28-May-10 20-May-10, 28-May-10
08-May-10, 13-May-10
08-May-10,
13-May-10 20-May-10, 28-May-10 08-May-10,
13-May-10 20-May-10, 28-May-10
08-May-10,
13-May-10 20-May-10, 28-May-10 20-May-10,
28-May-10
13-May-10, 20-May-10
08-May-10,
13-May-10 20-May-10, 28-May-10 13-May-10, 20-May-10
08-May-10, 13-May-10
Control Phase 8-May-10 8-May-10 13-May-10 8-May-10 28-May-10 28-May-10 28-May-10
Note: Nurse and Ward team can take process improvement project . Improve - Control Phase 20-May-10, 28-May-10 13-May-10, 20-May-10 08-May-10, 13-May-10 20-May-10, 28-May-10 20-May-10, 28-May-10
PROJECT PROJECT NAME PRESENT STATE Remarks
PROJECT 1
PROJECT 2 Outpatient Department- Lab delay
PROJECT 3 Patient registration time reduction
PROJECT 4
Billing : Inpatient billing process time reduction
Improve - Control phase
Process has improved from 16.6 min to 12.7 min. New improvement initiative has been taken ; circular to collect ward wise per visit per patient Doctor fee. Process is STABLE, NORMAL, and Cpk 0.5.
Define -
Measure Phase
1. One way ANOVA for tests and One way ANOVA for lab technician is done and there is a significant difference in atleast one test and one technician. Need to sort out the same, as some of the technicians are consistently having less time difference.
Analyse - Improve Phase
Peak hours have been identified to be 10hrs to 20hrs. Process Capability has improved from 0.6 Cpk to 1.6 Cpk, due to an improvement initiative of Direct Registration in computer without using registration form.
Discharge Delay Reduction for cash
patients Measure - Analyse Phase
Not able to get special cause with reason for Receiving billing card by billing department. Inititative taken to send billing card directly to billing department.
PROJECT 5
PROJECT 6 Employee's satisfaction
PROJECT 7
PROJECT 8 Pharmacy
Reducing the time of Cashless Insurance
approval Analyse - Improve Phase
Investigation document, Details of management, Previous consultation, Past history, Cause of illness, Final diagnosis are the fital few cause for delay in insurance approval. Remedy steps such as sending preauthol twice a day, FIRST at 11 hrs to 12 hrs for the patient admited previous day after 13 hrs. and Second at 18hrs to 19 hrs for the patient admited on the same day before 13 hrs. Mayor insurance cause delay was TTK,Star (gen),
VIPUL,Medicare, MD india.
Define -
Measure Phase Shameem absent, Shiva kumar is not aware of 6sigma.
To reduce the breakdown time of
maintenance equipments Measure - Analyse Phase
Identified 367.369,370,368 as the major power consuming services. A/C outdoor unit, All Rooms as the power consuming division of 367 services.
Measure - Analyse
PROJECT 9 Not visited
PROJECT 10 Increasing the reliability of the test resultsMeasure
PROJECT 11 Define New project
To provide timely, tasty hygienic dietary
care Analyse - Improve Phase
1. Actual process of Gauge R & R is clearly explained to Mr. Hari. 2. Need to create 5-S system in
consumables and other racks in lab 3. Need to implement the action plan To provide reduce the billing card time given to
PROJECT 12 Improve Nursing care satisfaction Not visited
PROJECT 13 Increase No. of Referral Cases
Improve - Control phase
Define -
Measure Phase
1. Process owner has completed getting 25 data points and the performance is still dipping. He has some reasons like off season for special cause in control chart of actual/targeted number of patients. 2. Have mooted the idea of wearing corporate uniform for brand identity and improving the consultant feedback forms for business
PROJECT 14 Improving quality of purchase process Measure Phase
PROJECT 15 To improve account receivable of insurance
1. Could not meet, as the process
owner is out on an exigency purchase. He has to continue with previous
suggestions and still improve his volume utilization.
Measure - Analyse Phase
Medicare TPA, TTK, Star health, MD India are the Vital few insurance causing 50% of delay in insurance sum to 70% of insurance value.
ACTION PLAN
1.Improvement initiative; fee for medical consultant has to be freezed.
1. Control chart's special causes needs to be addressed properly to improve process stability.
1.Standardized schedule 2. Queue formation. 3. Swapping of billing and reception team. 4. Introducing notificaiton period as 2month 5. Implementation of 5S
1. Check the One way anova B/W ward Vs Total discharge time, Total temprory bill, total final summary, Total final bill , Receive billing card by pharmacy, take final summary, receive written summary. 2.Doctors Vs total final summary.
1. Modify check list including the vital few delay caused document. 2. Identify the causes for the vital few authoriz-delaying insurance.3.Identify the average delay time for all the vital few insurance.
To Make the ratings as 4 3 0 and plot individual moving range chart and look for special cause.
1. Basement Consultant A/C Usage during the break monitor chart ( 14,15,16,17 hrs).2. Rooms extra bulb no. 3.Rooms A/C temperature at 9, 12,17.20.30 hrs 4. Understanding Operation theater A/C usage during non operation period 5. Operation theater data ( Date, Operation, Doctor, opertaion time, duration) 1. He has to identify both ABC class inventory items and fast
moving/slow moving inventory items. 2. He has to set reorder levels and max inventory levels for the items. 3. Take Visual pictures to demonstrate the improvement. 4. Have an
arrangement of medicines facilitating FIFO movement. 5. High cost non moving items and low profitability non moving items SKUs to be taken out immediately. Find alternate methods of procurement for non-returnable narcotics drug.
1. Twenty One Point Lessons for visual management.
2. Including visual pictures such as training and feedback collection of all the phases of improvement
3. Create a Dash board with photos and charts. Include only recent and penultimate data/six-packs.
4. Document all the improvements made in the recent past to demonstrate the sudden improvement in CpK from .53 to 1.53. 5. Make a presentation in the model given by Mr. Jayabalan for preparation towards ANQ meet discussed with C.O.O 6. Clock idea for knowing the locality of the
department head to be discussed with C.O.O
1. Investigate the special causes and take necessary corrective and preventive actions 2. Do one Gauge R& R in biochemist or hepatology departmental machines. 3. Create a quarantine zone for disposing hazardous waste. 1. Project charter 2. Project Milestone chart 3. Data 4.Control chart with special cause.
1. Start 5-S as a starting point for Voice of Business. 2. Twenty One Point Lessons for visual management.
3. Including visual pictures such as training and feedback
collection of all the phases of improvement 4. Create a Dash board with photos and
charts. Include only recent and penultimate data/six-packs. 5. Make a presentation in the model given by Mr. Jayabalan for preparation towards ANQ meet discussed with C.O.O 6. Create a documentation(either in soft or hard format) in chronological order for the project for project replication. 7. Toyota type shoe cleaner to be installed in the visitor area. Initiate the feasibility talks of buying such an instrument with C.O.O
Two control charts. 1. X-MR chart for both patients per week / no of doctors 2. Actual/Targeted number of patients per week. Both the control charts are explained to Ms. Banu Rekha. The control charts plotted shows definitive dip in the performance of the marketing in the last two months. The process owner needs to investigate the reasons and take counter measures.
1. Identification & Traceability of stores is found to be OK.
Checked the Fevi gum SKU in R7 C13 Rack 4 . 2. Reorder levels and max inventory level of the stores is also checked. 3. He has to put a pareto to identify A class items contributing to 80% of stock value. 4. Volume is still not effectively utilized in the storage areas of stationery rack.
1.Find the average delay time for the insurance company. 2. Implement improve intiative, such as consistent reminder well in advance. Daily phone call and mail 20 days before for TTK and Medicare and 14 days before for Star health and MD india.
PROJECT PROJECT NAME
PROJECT 1
PROJECT 2 Outpatient Department- Lab delay
PROJECT 3 Patient registration time reduction
PROJECT 4
PRESENT STATE
Billing : Inpatient billing process time reduction Improve - Control phase Define - Measure Phase Analyse - Improve Phase
Discharge Delay Reduction for cash patients
Measure - Analyse Phase
PROJECT 5
PROJECT 6 Employee's satisfaction
PROJECT 7
PROJECT 8 Pharmacy
PROJECT 9
PROJECT 10 Increasing the reliability of the test results Measure
PROJECT 11 Effective record maintenance
Reducing the time of Cashless Insurance approval Measure - Analyse Phase Define - Measure Phase To reduce the breakdown time of
maintenance equipments Measure - Analyse Phase Measure - Analyse Phase
To provide timely, tasty hygienic dietary care Analyse - Improve Phase Define Phase
PROJECT 12 Improve Nursing care satisfaction
PROJECT 13 Increase No. of Referral Cases
PROJECT 14 Improving quality of purchase process
PROJECT 15 To improve account receivable of insurance
Improve - Control phase Define - Measure Phase Measure Phase Define - Measure Phase
REMARKS
Refinement in data collection and monitoring needed Process was unstable and had ppk less than zero till march 23rd. Pareto on special cause have taken.
Found the following vial few special cause responsible for billing process delay Doctor phone not pick
up(DPNP)55% ,Unable to find a doctor due to busy in surgery (UCD-A) 15%, Discussion with internal staff (DIS) 10% . Management has helped billing team to take the following action, a) Update the billing amount in billing card from doctor before discharge b) Give prior intimation to doctor for collecting the doctor fee. This action has resulted changes from 26 th march 2010.The process is stable with Mean = 16.6 minutes, ppk = 0.39, ppm =130560 . By this process , billing department were able to bring process from 36 min to 16.6 min, and save Rs.36 per hour.
Phone call interruption, New staff and Direct enquiry where found to be the vital few special cause. Phone instrument has been shifted from registration spot. But still reception team were distracted by phone call.
IP discharge process has been expressed in equation as below, Total temporary bill (60min) = Receiving discharge slip (15 min) + Receiving billing card by ward secretary (5min) + Receiving billing card by pharmacy(20 min)+Receiving billing card by billing (5 min) +Generate temporary bill (15min). Total
discharge summary (45 min) = Receive written summary(20 min)+ Take final summary (20 min)+ Hand over summary to ward (5 min).Pareto was drawn on frequency of target failed incidence on the above activity. It was found the vital few cause for delay in Total temporary bill was Receiving billing card by billing department, Receiving billing card by
pharmacy. Also the vital few cause for delay in Total discharge summary was Take final summary and receiving written summary.
Project owner not available
Data collection process have got refined with No. of query, Reason for query, % of approval and Query type by the team.GOPINATH CAN ALSO SHARE THE PROJECT OWNERSHIP OF THIS PROJECT WITH VIJAYALAKSHMI.
Plotting and interpretation of chart has to be improved.
Control chart for all the nine services data show they are stable. Major power consuming services was identified to be 367,369, 337 and 368.
Needs to do 5-S in stores. Could see a marked improvement in the arrangement of the items in the pharmacy.
Find out special causes in the recent control charts for further improvement. Please enumerate all the
hypothesis testing and ANOVA used to improve /identify the problem points.
Plot the control charts and bring in stability and histogram for normality.
Sustain achieved 6 sigma level of quality. Please enumerate all the hypothesis testing and ANOVA used to improve /identify the problem points. Enumerate the turning point of your project. What did you do to achieve six sigma quality. In specific, how the
variation has gone down. Please create a campaign among all the hospital employees.
Understanding of the chart is yet not clear. Team Leader has the responsibility of making him
understand the importance of drawing control charts and their interpretations.
Communication of the time of request should be standardized and authorized by C.O.O to effectively monitor the time of issue. Control chart
understanding is not very clear. The inventory records and reorder level should be automated by the
software alarms. The location of the stock is not yet updated in the system.
Operational definition on the delay date on receivable of insurance.
ACTION PLAN
1) Draw Pareto with inference for medical case. 2) Brainstorm actions for the vital few.
1.Plot difference(target time to actual time) with XMR chart. 2.Pareto on types of test.
1) Identify the peak hours using pareto. 2) Refine schedule with one receptionist dedicated for attending phone call and enquiry during peak hour. 3) Implement 5S to
arrange the most needed item near to your hand.
1) Draw control chart with special cause for Receiving billing card by billing department, Receiving billing card by pharmacy, Take final
summary and Receiving written summary. 2) Pareto for the special cause and find the vital few special cause.
Management need to take call on this project
1) Redefine query type 2) Pareto based on query type 3) Pareto on the frequency of delay on insurance company.
To Make the ratings as 4 3 0 and plot individual moving range chart and look for special cause. 1) Identify major power consuming devices in each identified services. 2) Brainstorm on methods to reduce power consumption on these identified devices.
1. He has to identify both ABC class inventory items and fast moving/slow moving inventory items. 2. He has to set reorder levels and max inventory levels for the items. 3. Take Visual pictures to demonstrate the improvement. 4. Have an arrangement of medicines facilitating FIFO movement.
1. Twenty One Point Lessons for visual management. 2. Including visual pictures such as training and feedback collection of all the phases of improvement
3. Create a Dash board with photos and charts. Include only recent and penultimate data/six-packs. 4. Document all the improvements made in the
recent past to demonstrate the sudden improvement in CpK from .53 to 1.53.
5. Make a presentation in the model given by Mr. Jayabalan for preparation towards ANQ meet
discussed with C.O.O 6. Clock idea for knowing the locality of the department head to be discussed with C.O.O
1. Investigate the special causes and take necessary corrective and preventive actions 2. Do one Gauge R& R in biochemist or hepatology departmental machines. 3. Create a
1. Start 5-S as a starting point for Voice of Business. 2. Twenty One Point Lessons for visual management. 3. Including visual pictures such as training and feedback collection of all the phases of improvement 4. Create a Dash board with photos and charts. Include only recent and penultimate data/six-packs.
5. Make a presentation in the model given by Mr. Jayabalan for preparation towards ANQ meet
discussed with C.O.O 6. Create a documentation(either in soft or hard format) in
chronological order for the project for project replication. 7. Toyota type shoe cleaner to be installed in the visitor area. Initiate the feasibility talks of buying such an instrument with C.O.O
Two control charts. 1. X-MR chart for both patients per week / no of doctors 2. Actual/Targeted number of patients per week. Both the control
charts are explained to Ms. Banu Rekha. The control charts plotted shows definitive dip in the
performance of the marketing in the last two months. The process owner needs to investigate the reasons and take counter measures.
1. Identification & Traceability of stores is found to be OK. Checked the Fevi gum SKU in R7 C13 Rack 4 . 2. Reorder
levels and max inventory level of the stores is also checked. 3. He has to put a pareto to identify A class items contributing to 80% of stock value. 4. Volume is still not
effectively utilized in the storage areas of stationery rack.
1.Pareto on frequency of delay from insurance
company. 2. Stratify Insurance company based on the pending amount.
PROJECT PROJECT NAME
PROJECT 1
PROJECT 2 Outpatient Department- Lab delay
PROJECT 3 Patient registration time reduction
PROJECT 4
PROJECT 5
PROJECT 6 Employee's satisfaction
PROJECT 7
PROJECT 8 Pharmacy
PROJECT 9
PROJECT 10 Increasing the reliability of the test results Measure PROJECT 11 Effective record maintenance
PROJECT 12 Improve Nursing care satisfaction
PROJECT 13 Increase No. of Referral Cases
PROJECT 14 Improving quality of purchase process PROJECT 15 To improve account receivable of insurance
PRESENT STATE Billing : Inpatient billing process time
reduction Measure Phase
Define - Measure Phase Analyse - Improve Phase Discharge Delay Reduction for cash
patients
Measure - Analyse Phase
Reducing the time of Cashless Insurance
approval Measure Phase
Define - Measure Phase
To reduce the breakdown time of maintenance equipments Measure - Analyse Phase Define - Measure Phase To provide timely, tasty hygienic dietary
care Analyse - Improve Phase Define Phase Improve - Control phase Define - Measure Phase Measure Phase Define - Measure Phase
REMARKS
Data collection need to be improved
Understanding of chart need to be clear.
Need to find areas of improvements Understanding of chart need to be clear. Project owner not available
Sustain achieved 6 sigma level of quality.
Understanding of chart need to be clear. Understanding of chart need to be clear. Control chart plotting and interpretation. Too many special cause, Not clear
stratification of special cause.
Refinement in data collection and monitoring needed
Vital few special cause have been identified using Pareto. Counter measure need to be refined.
Countable non value adding activity. Need good Co-ordination among Ward secretory, Nursing, Billing and Pharmacy
Plotting and interpretation of chart has to be improved.
ACTION PLAN
To send complete data start to end time in excel.
Management need to take call on this project
Control chart with special cause.
Month wise Control chart with special cause and Month wise Pareto on Special cause
1.Plot difference(target time to actual time) with XMR chart. 2.Pareto on types of test.
Implementation of counter measure. Assess process improvement due to counter measure change using control chart and Pareto .
Pareto on IP discharge delay based on support team wise. Control chart with special cause on IP
discharge and support team.
Number of queries before approval, categories the queries, and draw pareto for the same. X MR chart for time taken for pre authorization form filling. Enhancemennt queries categorisation and pareto. To Make the ratings as 4 3 0 and plot individual moving range chart and look for special cause.
1.To use multiline chart. 2.To record benefits due to change lift operation. 3.To record data on a) IP per day, b) No. of OT1 and OT2 operation per day, c) No. x-rays per day. 4. To explore possibilities of motion sensor light in basement on trail basis.
Application of Analitical tools to statisticaly highlight the process state.
Control chart with special cause. Pareto chart based on special cause
Project on reducing defects and rework in Discharge card.
Month wise data - a) No. of doctors refered b) No. of IP refered data.
Pareto on insurance company based on no. of patient refered. Control chart for Insurance claim time.
