AFRICAN DEVELOPMENT BANK

N/A
N/A
Protected

Academic year: 2021

Share "AFRICAN DEVELOPMENT BANK"

Copied!
17
0
0

Loading.... (view fulltext now)

Full text

(1)

AFRICAN DEVELOPMENT BANK

EMERGENCY POWER INFRASTRUCTURE REHABILITATION PROJECT -

PHASE I

SUPPLEMENTARY GRANT PROPOSAL

COUNTRY

: ZIMBABWE

APPRAISAL REPORT

ONEC DEPARTMENT

(2)

Table of Contents

Grant Information ... i

Currency Equivalents ... ii

Acronyms and Abbreviations ... ii

RESULT MATRIX ... iii

EXECUTIVE SUMMARY ... v

1 INTRODUCTION ... 1

2 ORIGINAL PROJECT ... 1

2.1 Project Background and Origin ... 1

2.2 Project Objective ... 1

2.3 Project Components ... 2

2.4 Project Costs and Financing Arrangements ... 2

2.5 Project Implementation Status ... 3

2.5.4 Rehabilitation of the Ash Plant at Hwange Power Station ... 3

2.5.5 Sub-Transmission and Distribution System Reinforcement ... 3

2.5.6 Consultancy for Environmental and Social Audit ... 4

2.5.7 Consultancy for Project Supervision ... 4

2.5.8 Consultancy for Project Accounts Audit... 4

2.5.9 Environmental Monitoring and Capacity Building ... 4

3 REVISED PROJECT FINANCING... 5

3.1 Objectives and Description ... 5

3.2 Revised Project Cost estimates ... 5

3.3 Revised Implementation Schedule ... 6

3.4 Project Implementation ... 6

3.4.2 Institutional Arrangement ... 6

3.4.3 Monitoring and Evaluation ... 6

3.4.4 Social and Environmental Management Plan ... 6

4 JUSTIFICATION FOR SUPPLEMENTARY FINANCING ... 7

5 LEGAL INSTRUMENTS AND AUTHORITY ... 8

5.1 Legal Instrument ... 8

5.2 Conditions Associated with Bank’s Interventions ... 8

5.2.1 Conditions Precedent to Entry into Force of the Grant ... 8

5.2.2 Conditions Precedent to First Disbursement of the Grant ... 8

5.3 Compliance with Bank Policies ... 8

6 CONCLUSION AND RECOMMENDATION ... 8

6.1 Conclusion ... 8

6.2 Recommendation ... 8 Annex I – Project Costs

(3)

i

Grant Information

Client’s information

RECIPIENT: Government of the Republic of Zimbabwe

Financing plan

ADB’s key financing information

Supplementary Grant USD 4.61 million

Interest type* N/A

Interest rate spread* N/A

Commitment fee* N/A

Other fees* N/A

Tenor N/A

Grace period N/A

Timeframe - Main Milestones (expected)

Approval of Supplementary Financing by Zim-Fund POC 25/07/2013 Approval of Supplementary Financing by AfDB Board 13/11/2013

Effectiveness 25/11/2013

Last Disbursement 31/12/2014

Source Amount (USD)

million

Instrument

Zim-Fund 4.61 Grant

(4)

ii

Currency Equivalents

July 2013

1UA = US Dollar (USD) 1.50396

FISCAL YEAR:

1 Jan – 31 Dec

Acronyms and Abbreviations

AfDB African Development Bank MTP Medium Term Plan

ADF African Development Fund MVA Megavolt ampere (1,000 kVA) CAP Consolidated Appeal Framework NCB National Competitive Bidding EIRR Economic Internal Rate of Return NGO Non-Governmental Organization

ESMP Environmental and Social Management Plan

O&M Operation and Maintenance

EPIRP Emergency Power Infrastructure Rehabilitation Project

PA Procurement Agency

ESIA Environmental and Social Impact Assessment

PMT Project Management Team

GOZ Government of Zimbabwe POC Programme Oversight Committee GPA Global Political Agreement STERP Short Term Emergency Rehabilitation

Program

HPS Hwange Power Station T&D Transmission and Distribution IE Implementing Entity Tx Transformer

IG Inclusive Government WACC Weighted Average Cost of Capital km Kilometer USD United States Dollar

kV Kilovolt (1,000 volts) VAR Volt-Ampere Reactive MDTF Multi Donor Trust Fund ZEMA Zimbabwe Environmental

ManagementAuthority

MMU MDTF Management Unit ZESA Zimbabwe Electricity Supply Authority MOENRM Ministry of Environment and Natural

Resources Management

ZETDC Zimbabwe Electricity Transmission and Distribution Company

MOEPD Ministry of Energy and Power Development

Zim-Fund Zimbabwe Multi-Donor Trust Fund

MOF Ministry of Finance ZPC Zimbabwe Power Company MOHCW Ministry of Health and Child

(5)

iii

RESULT MATRIX Country and project name: Zimbabwe, Emergency Power Infrastructure Rehabilitation Project Phase I

Purpose of the project : Improve availability and reliability of electricity supply to critical social infrastructure facilities and the people of Zimbabwe

RESULTS CHAIN

PERFORMANCE INDICATORS MEANS OF

VERIFICATION RISKS/MITIGATION MEASURES Indicator (including CSI) Baseline Target IM P AC

T The power production capability of the installed capacity fully restored

Utilised installed capacity 1237 MW in 2012 1960 MW by 2016 ZESA, ZPC Annual Reports; O UT CO M E S 1.Improved availability of electricity

1.1Electrical energy production at Hwange Power Station

3133 GWh in 2012 4800 GWh by 2016

ZPC Annual Reports

Risk 1: Revenue risk leading to failure to properly operate, and maintain the rehabilitated facilities.

Mitigation Measures: (1) Ensure that the design of the equipment installed during the Project is robust and of low

maintenance and (2) support ZESA to lobby for gradual tariff adjustment towards a cost reflective tariff through regular Bank/Government dialogue meetings. .

Risk 2: Vandalism of rehabilitated facilities

Mitigation Measures: Enhance security around the refurbished installations and Bank support ZESA to lobby for enforcement of legislation that criminalizes acts of vandalism and reduction in power outages ensuring that the system is live most of the time. 2.Access to reliable

electricity supply

2.1Number of customers accessing continuous electricity supplies in selected project areas

227, 280 customers in 2012 249,280 by 2016 ZESA and ZETDC Annual Reports 3.Improved environmental quality at HPS and surroundings

3.1Level of air particulates in the air at Hwange Power Station and surroundings 273 mg/m3 in 2012 180 mg/m3 by 2016 ZPC Annual Reports O UT P UT S 1.Distribution Network Infrastructure upgraded and rehabilitated 1.1: 11/0.4kV & 33/0.4kV distribution transformers installed (No.) 0 in 2012 521 by 2016 Implementing Entity Project Progress Reports; MMU Weekly, Monthly & Quarterly Reports

Risk 1: Implementation delays

Mitigation Measures: i) Engagement of independent procurement agent; ii) Engagement of independent

implementing entity; iii) Closer follow up by MMU and Project Steering

Committee; iv) Effective involvement of 1.2: Distribution lines rehabilitated (km) 0 km in 2012 287 by 2016 1.3Distribution cables rehabilitated (km) 0 km in 2012 21 by 2016

(6)

iv

Country and project name: Zimbabwe, Emergency Power Infrastructure Rehabilitation Project Phase I

Purpose of the project : Improve availability and reliability of electricity supply to critical social infrastructure facilities and the people of Zimbabwe

RESULTS CHAIN

PERFORMANCE INDICATORS MEANS OF

VERIFICATION RISKS/MITIGATION MEASURES Indicator (including CSI) Baseline Target 2.Sub-Transmission Capacity Strengthened 2.1Sub-transmission level transformers installed (No.)

0 in 2012 7 by 2016

Bank Supervision Mission Reports

Audit report

Project Management Teams, and v) Better coordination through sector governance structures;

2.2Sub-transmission level circuit breakers installed(No.)

0 in 2012 16 by 2016

3.Hwange Power Station Rehabilitated:

3.1Replace wet ash handling system

Old ash handling system in 2012

Completion of Ash Dam rehabilitation works by 2016 3.2Construct new ash plant

control room

Old ash plant in 2012 Control room completed by 2016 3.311kV transformer cable (km) Old cables in 2012 0.50 by 2016 3.43.3kV 3-core cables (km) Old cables in 2012 o.50 by 2016 4.Audit Services 4.1Project Audit Produced 0 in 2012 4 by 2016

INPUTS K E Y ACTI VI T IE S

Component A: Rehabilitation of the Ash Handling Plant at Hwange Thermal Power Station:

Component B: Rehabilitation of sub-transmission facilities and Rehabilitation of distribution facilities Component C : Environmental Audit

Component D: Engineering &Project Management Consultants Component E: Audit

Component F : Environmental Monitoring and Capacity Building

Component A: USD 10.62million

Component B: USD 23.91 million

Component C: USD 0.79million

Component D:USD 1.83million

Component E:USD 0.06million

Component F: USD 2.40 million

(7)

v

EXECUTIVE SUMMARY

In June 2011, the Board of Directors approved a grant amounting to USD 35 million to finance the Emergency Power Infrastructure Rehabilitation Project (EPIRP I or the Project) targeting the power transmission and distribution facilities throughout the whole country and the rehabilitation of the Ash Handling Plant at the Hwange Power Station in Hwange. The Protocol of Agreement was signed in September 2011. The envisaged outcomes of the intervention include: improved environmental management and ash handling at the Hwange Power Station, improved reliability of sub-transmission and distribution networks, and improved electricity supply to the water treatment plants of Harare City and other urban water supply systems. Following the recruitment of the Implementing Entity (IE) in October 2011 and the Procurement Agent (PA) in November 2011, the Project was launched in December 2011. Since then, considerable progress has been achieved in the implementation of the Project. The technical assessments, definition of scope of works and services and preparation of procurement documents were completed followed by the launch of the procurement process. The bid evaluation has been completed for the three packages involving physical works and for three packages for consultancy services. The following contracts have been awarded: the Rehabilitation of the Hwange Power Station ash dam (EPIRP/002), the Sub-transmission Facilities reinforcements (EPIRP/003), the Distribution System Reinforcement (EPIRP/004) the Environmental and Social Audit (EPIRP/005) and the Project Audit (EPIRP/006). The Environmental Monitoring and Capacity Building contract requires inputs from the Environmental and Social Audit contract and will be awarded after its commencement. Despite the progress made in the procurement process, the prices obtained for two of the bids have been higher than the budgeted figures in the Project Appraisal Report, ADB/BD/WP/2011/96/Rev.1/Approved, as well as the engineer’s estimate. Generally, the reasons for the high bid price outcomes were mainly due to: (i) negative perceptions about Zimbabwe and its dollarized economy; (ii) lack of recent, similar projects with a similar scale in Zimbabwe to use as references; (iii) the rehabilitation nature of the works and the lack of sufficient documented information on the current state of the system; (iv) difficult and unreliable cost estimating in current day Zimbabwe; and (v) the short implementation periods required for the projects. Taking into account the concluded bidding processes and contingencies to cater for unforeseen expenditures during the implementation process, the expected total value of the Project is now estimated at USD 39.61 million. The additional resources required therefore amount to USD 4.61 million.

If the Project goals and objectives as set out in the PAR are to be met, the Project must be completed as per the original plan. The additional resources being requested will make it possible for the Project to be completed as planned and achieve its goals.

(8)

1

REPORT AND RECOMMENDATION OF THE MANAGEMENT TO THE BOARD OF DIRECTORS ON A PROPOSED SUPPLEMENTARY GRANT

FROM THE RESOURCES OF THE ZIM-FUND TO ZIMBABWE FOR THE EMERGENCY POWER INFRASTRUCTURE REHABILITATION PROJECT (EPIRP I)

Management hereby submits this proposal and recommendations concerning a proposal for a US$ 4.61 million supplementary grant to the Republic of Zimbabwe from the resources of the Zimbabwe Multi-Donor Trust Fund (Zim-Fund) to finance the full implementation of the EPIRP I.

1 INTRODUCTION

1.1 It is to be recalled that on 30 June 2011, the Board approved on a lapse-of-time basis financing of the EPIRP I targeting the rehabilitation of the ash handling plant at Hwange Power Station, the sub-transmission facilities and distribution system throughout the country, and other related activities.

1.2 The original estimated cost of the Project was USD 35 million and the disbursement rate as of 31 August 2013 was at 9.13%. The Project Protocol of Agreement was signed on 14 September 2011, and the Project was launched on 15 December 2011 following the recruitment of the Implementing Entity (IE) in October 2011 and the Procurement Agent (PA) in November 2011. This was followed by technical assessments, provision of bid documents, and commencement of the bidding process. By 31 December 2012, the tendering of the major components of the Project was completed, except for Environmental Monitoring and Capacity Building (EPIRP/007). The tendering for several of the Project components resulted in bid prices higher than the budgeted amounts. Due to the importance of implementing the full scope of the Project for achieving the Project objectives, this proposal is requesting supplementary financing in the amount of USD 4.61 million to enable the full implementation of the Project as originally envisaged.

2

ORIGINAL PROJECT

2.1 Project Background and Origin

2.1.1 The political and economic situation in Zimbabwe for the last decade has severely affected all sectors of the economy including infrastructure. In this regard, the rehabilitation of key power sector assets in the generation, transmission and distribution systems has been identified as the fastest and least cost option for restoring capacity to increase electricity supply in order to meet part of the current electricity demand and enhance system stability. Following the outbreak of Cholera in the country in 2008, it was imperative for the water and sanitation situation to be urgently addressed. In order to address the situation it was also observed that the reliability and availability of power supply in the country had to be improved, hence the need for the Emergency Power Infrastructure Rehabilitation Project.

2.2 Project Objective

2.2.1 The objective of the Project is to improve the provision of adequate and reliable power supply in an environmentally sound manner through the rehabilitation of the ash handling plant at Hwange Power Station and the sub-transmission and distribution facilities in the country. The Project will also help to improve the reliability of electricity supply to the treatment plant of the Harare city water supply and other urban water supply systems and thereby help prevent another cholera outbreak in the country.

(9)

2 2.3 Project Components

2.3.1 The Project complements the ongoing power sector infrastructure rehabilitation program identified by ZPC and ZETDC, subsidiaries of ZESA Holdings mandated to operate and maintain the Hwange power station and transmission & distribution networks respectively. Components included in the project were selected from a list of critical interventions that need to be conducted in the rehabilitation of power infrastructure to bring the power system to an acceptable level of performance. The identification of the Project components was undertaken by the stakeholders - ZESA, ZPC, ZETDC, the Ministry of Energy and Power Development and the Ministry of Finance - as the priority activities to be supported by the limited funds available. The Project comprises six components:

(A) Rehabilitation of Ash Plant at Hwange Power Station; (B) Sub-Transmission and Distribution Reinforcement; (C) Consultancy for Environmental and Social Audit; (D) Consultancy for Project Supervision;

(E) Consultancy for Project Accounts Audit; and (F) Environmental Monitoring and Capacity Building. 2.4 Project Costs and Financing Arrangements

2.4.1 The total cost of the EPIRP Phase I was estimated at USD 35.00 million, excluding the cost of the services of a procurement agent which is being financed separately through the Fragile States Facility (FSF). This was the amount approved respectively by the Zim-Fund Project Oversight Committee (POC) for implementation of Phase I, and the Board. Table 1 summarizes aggregate costs of the various project components at project appraisal stage.

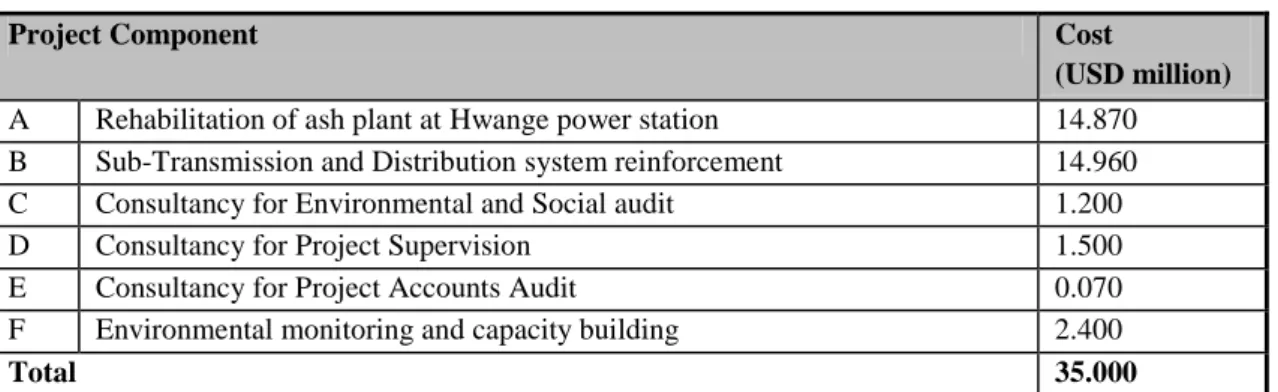

Table 1: Original Project Cost Estimates by Component

Project Component Cost

(USD million)

A Rehabilitation of ash plant at Hwange power station 14.870 B Sub-Transmission and Distribution system reinforcement 14.960 C Consultancy for Environmental and Social audit 1.200 D Consultancy for Project Supervision 1.500 E Consultancy for Project Accounts Audit 0.070 F Environmental monitoring and capacity building 2.400

Total 35.000

Table 2: Original Project Cost by Category of Expenditure

Category of Expenditure USD (million)

A. Works 32.13

B Services 2.87

C Miscellaneous 0.00

(10)

3 2.5 Project Implementation Status

2.5.1 Despite being approved by the Board in June 2011, the conditions for the first disbursement were fulfilled in May 2012. This resulted in the late commencement of the technical assessment phase of the Project. The overall slippage from the indicative schedule in the PAR is estimated at 12 months.

2.5.2 Despite the delays, the Project has made steady progress. USD3.2 million was disbursed by end of August 2013 with the project having achieved the following milestones:

 Completion of the technical assessment and definition of scope of works and services,

 Preparation of procurement documents;

 Launch of procurement process including prequalification process;

 Completion of tender evaluation for 5 out of a total of 6 packages;

 Negotiations and award of five contracts (EPIRP/002, EPIRP/003, EPIRP/004, EPIRP/005 and EPIRP/006). Only one contract (EPIRP/007) is yet to be awarded.

 Implementation of the awarded contracts is progressing well.

2.5.3 The paragraphs below provide the detailed status of implementation of each component of the Project.

2.5.4 Rehabilitation of the Ash Plant at Hwange Power Station

This component entails the replacement and refurbishment of various pumps, discharge lines, low voltage and medium voltage cables in the ash handling plant at Hwange Power Station. The main outcome of this will be improved environmental management at Hwange Power Station ash plant. The Specific Procurement Notice (SPN) for the pre-qualification of bidders for this component closed on 26th July 2012. The only one bidder that was pre-qualified for this package pulled out on 7 November 2012. Thus it was agreed to change the mode of procurement to Limited International Bidding and eleven bidders were pre-qualified for the bid. The bids for this bidding process were opened on 9 April 2013. The bid evaluation for this complex rehabilitation package was completed during the second week of July 2013. The contract was awarded in August 2013 with an eight month contract delivery period.

2.5.5 Sub-Transmission and Distribution System Reinforcement

Sub-Transmission System Reinforcement: The sub-transmission part of this component involves the supply, installation and commissioning of seven power transformers and sixteen 132 kV circuit breakers at various substations throughout the country. The contract for this package was awarded in January 2013. Orders have been placed for equipment which is currently being manufactured. The target completion date for this contract is 4 January 2014.

Distribution System Reinforcement : The distribution part of this component consists of the supply, installation and commissioning of 521 distribution transformers and construction of 287 km of distribution overhead lines and 12 km of underground cables. The contract for this package was awarded in February 2013. The equipment and materials are at various stages of being manufactured in South Africa and India. The target completion date for this contract is April 2014.

(11)

4 2.5.6 Consultancy for Environmental and Social Audit

Consultancy has been procured to carry out an Environmental and Social Audit of the whole Hwange power plant and its operations and a comprehensive Environmental and Social Management Plan prepared for the plant. The contract was awarded in August 2013 and is expected to be completed in July 2014.

2.5.7 Consultancy for Project Supervision

The GOZ, with the assistance of the Zim-Fund Management Unit (MMU), procured the services of Parsons Brinkerhoff as an Implementing Entity for the Project through advance contracting procedures. The IE provides project management, coordination, technical assessment, preparation provision of technical documents for tenders and supervision services. The IE is also responsible for project financial management including accounting and financial reporting. The IE and GOZ signed the Implementing Entity Agreement in October 2011, with the IE mobilization commencing in December 2011.

To date, the IE has completed technical assessments, provided technical inputs for tender bidding documents preparation, prequalification, bidding and evaluation process and contract award negotiations. With the technical input from the IE, the Procurement Agent is effectively leading and administering the procurement process. The procurement process for most of the packages has been completed and the next phase of the PA’s role is now administering the contracts on behalf of the GOZ. The IE will play the role of Engineer to supervise the works and services to be provided.

2.5.8 Consultancy for Project Accounts Audit

The project audit for year ending 2012 is being finalized. The Project audit contract was awarded in May 2013, and the auditor is working on the report for the period ending 2012. The audit services will include both the EPIRP I and the Zim-Fund Urgent Water Supply and Sanitation Rehabilitation Project I.

2.5.9 Environmental Monitoring and Capacity Building

This package is made up of an environmental consultancy services to provide Capacity Building of the Environmental Monitoring Unit at Hwange Power Station and works for the procurement of Air Quality Monitoring Equipment for the station. The procurement of this component will be initiated after the completion of the environmental and social audit.

(12)

5

3 REVISED PROJECT FINANCING

3.1 Objectives and Description

3.1.1 The project objectives have not changed and remain as described in the PAR, as set out in section 2.2 above.

3.2 Revised Project Cost estimates

3.2.1 The bidding process for all the items in the Project except for one (Environmental Monitoring and Capacity Building) has been completed and the comparison between the cost estimates by the IE after the scoping exercise and the costs from the bidders is shown in Table 3. The bid prices for the Sub-transmission and Distribution System Reinforcement component of the Project were substantially higher than the revised cost estimate.

3.2.2 The reasons for the high bid prices were mainly due to:

 Negative perceptions about Zimbabwe and its dollarized economy;

 Lack of recent, similar projects with a similar scale in Zimbabwe to use as references;

 The rehabilitation nature of the works and the lack of sufficient documented information on the current state of the system;

 Difficult and unreliable cost estimation in current day Zimbabwe; and

 The short implementation periods.

 The inclusion of some items that were considered to be essential in addressing the further deterioration of the distribution network in Harare.

 The Project Appraisal cost estimates were not based on a detailed feasibility study.

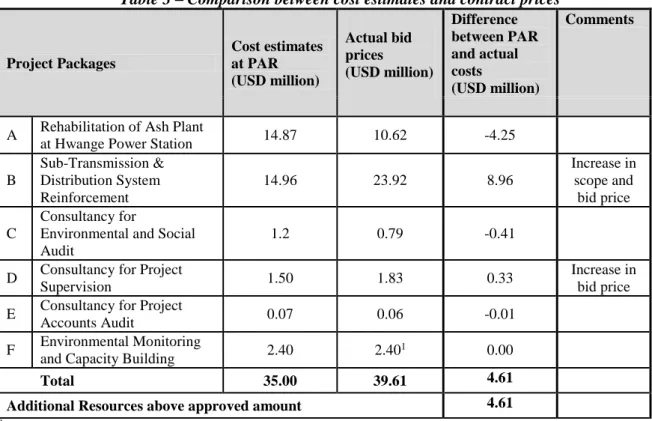

Table 3 – Comparison between cost estimates and contract prices

Project Packages Cost estimates at PAR (USD million) Actual bid prices (USD million) Difference between PAR and actual costs (USD million) Comments

A Rehabilitation of Ash Plant

at Hwange Power Station 14.87 10.62 -4.25

B Sub-Transmission & Distribution System Reinforcement 14.96 23.92 8.96 Increase in scope and bid price C Consultancy for

Environmental and Social Audit

1.2 0.79 -0.41

D Consultancy for Project

Supervision 1.50 1.83 0.33

Increase in bid price E Consultancy for Project

Accounts Audit 0.07 0.06 -0.01 F Environmental Monitoring

and Capacity Building 2.40 2.40

1 0.00

Total 35.00 39.61 4.61

Additional Resources above approved amount 4.61

(13)

6

Table 4: Supplementary Financing Categories of Expenditure

Categories of Expenditure Amount (USD million)

A Works 4.61

B Services 0.0

C Miscellaneous 0

TOTAL 4.610

3.2.3 Considering the concluded bidding process and making estimates for outstanding contracts and a contingency, the expected total cost of the Project is estimated at the revised amount of USD 39.61 million as shown in Table 3. Additional resources amounting to USD 4.61 million are therefore required for the Project to achieve its original goals and objectives.

3.3 Revised Implementation Schedule

3.3.1 The Project was originally planned to be implemented over a period of 21 months. The contracts for the various project components were originally expected to have been signed by late November 2011. However, due to the various delays experienced in the implementation process, the first contracts were signed in March 2013. Project completion for all packages is now targeted at the end of 2014. The revised implementation schedule is shown in Annex II. 3.4 Project Implementation

3.4.1 Implementation Arrangement

The Project will continue to be implemented within the framework of the instrument establishing the Zim-Fund and its Operations Manual. In this regard, an independent Project Implementation Entity (IE) will be responsible for implementation coordination, and monitoring while the procurement services will be provided by an experienced independent Procurement Agent (PA) already appointed for the project.

3.4.2 Institutional Arrangement

There will be no change to the institutional arrangements. That is to say, the IE will be assisted by Project Management Teams (PMTs) that have been set up within ZPC and ZETDC for general coordination. The already set up Project Steering Committee (PSC) comprising representatives from ZPC, ZETDC, Ministry of Energy and Power Development, and Zim-Fund MMU will continue to address all major issues in connection with the Project, and will provide overall guidance during project implementation.

3.4.3 Monitoring and Evaluation

Zim-Fund is developing a Monitoring and Evaluation (M&E) framework to support the project.The logframe was retrofitted into the new format and in the process the outcome indicators revised in line with the requirements for M&E.

3.4.4 Social and Environmental Management Plan

An Environmental and Social Management Plan for Hwange Power Station was developed by ZPC, and an independent environmental and social audit is being done under the Project (Contract No. EPIRP/005) which will be followed by the Environmental Monitoring and Capacity Building component (Contract No. EPIRP/007). The Environmental and Social Management Plans for the sub-transmission and distribution packages have been systematically

(14)

7

included in the works packages for implementation by the contractor, and its implementation will be monitored and supervised by the current IE ( Parsons Brinkerhoff).

4 JUSTIFICATION FOR SUPPLEMENTARY FINANCING

4.1 The supplementary financing proposal was approved on 25 July 2013 by the POC of the Zim-Fund, which is composed of the Zim-Fund donors and GOZ representatives, after consideration of the importance of achieving the original objectives of the Project. The Project is in alignment with the Bank Group’s 2011-2013 Zimbabwe Country Brief (as well as the draft 2013 – 2015 version) and the Bank’s Strategy (2013-2022) focus on infrastructure development. The inadequate provision or lack of reliable power supply services has affected the people of Zimbabwe more so the poor. It therefore significantly responds to the inclusive agenda and should be supported for the achievement of the full Project objectivewhich is also in line with GOZ Medium Term Plan for 2011 - 2015.

4.2 This supplementary financing proposal meets the applicable general conditions and specific conditions for supplementary financing set out in the Bank Group Policy and Procedures for Supplementary Financing (ADB/BD/WP/97/83). The following factors have been considered in submitting this proposal:

(i) The execution of the Project has commenced and is progressing satisfactorily from the technical perspective but will require additional resources to achieve its objectives.

(ii) The cost increases are beyond the control of the GOZ, and the GOZ is not in a position to provide additional financing.

(iii) There is need to build upon the recent power sector interventions so as to improve the

deteriorated power supply infrastructure in the country. A delay in improvement of power supply services has high tangible and nontangible economic and social costs.

(iv) It has not been possible to reduce the total cost of the project through changes of specifications or scope of work or services without significantly affecting the objective of the Project

(v) The project is technically and economically viable even with the cost overruns.

(vi) The Project cannot be reduced in size without damaging its ability to achieve the set objectives or its sustainability.

(vii) There are no exogenous constraints: financial, managerial, or technical – that would hinder the completion of the Project

(15)

8

5 LEGAL INSTRUMENTS AND AUTHORITY

5.1 Legal Instrument

5.1.1 The legal instrument to finance the supplementary grant will be a Protocol of Agreement between the Republic of Zimbabwe (the Recipient) and the Bank, in its capacity as the administrator of the Zimbabwe Multi-Donor Trust Fund (Zim-Fund), for a grant from the resources of the Zim-Fund.

5.2 Conditions Associated with Bank’s Interventions

5.2.1 Conditions Precedent to Entry into Force of the Grant

 The Protocol of Agreement will enter into force on its date of signature by the Recipient and the Bank.

5.2.2 Conditions Precedent to First Disbursement of the Grant

 The conditions precedent to first disbursement of the initial grant, which will be extended to the supplementary grant, have been fulfilled. As such, disbursements may be made from the supplementary grant upon entry into force of the Protocol of Agreement.

5.3 Compliance with Bank Policies

5.3.1 The proposed supplementary grant complies with all applicable Bank policies, including the Bank Group Policy and Procedures for Supplementary Financing.

6 CONCLUSION AND RECOMMENDATION

6.1 Conclusion

6.1.1 Priced bids received from the tendering process have been significantly higher than the budgeted figures from the estimates arrived at during the Project appraisal stage. Considering the concluded bids and estimates on the outstanding packages and the requirements during execution, the expected total value of the works is estimated at USD 39.61 million, thus additional resources of USD 4.61 million (13.2% of the original estimated Project costs) is needed in order to achieve the objectives of EPIRP.

6.2 Recommendation

6.2.1 Considering the many socio-economic and environmental benefits of this Project, it is recommended that the Bank approves this supplementary grant, from the resources of the Zim-Fund, for the amount of USD 4.61 million for the EPIRP.

(16)

Annex I – Project Costs

Component Package Number Description Budget as appraised (USD) Actual Contract (USD) Additional Resource Required (USD)

Rehabilitation of ash plant at Hwange power station

EPIRP/002 Ash Plant Upgrade and Rehabilitation

14,870,000 10,615,500 -4,254,500

Sub-transmission and Distribution Reinforcement

EPIRP/003 Sub-Transmission Facilities Reinforcement

4,960,000 8,565,535.77 3,605,535.77

EPIRP/004 Distribution System Reinforcement

10,000,000 15,352,498 5,352,498 Consultancy for Environmental

and Social Audit

EPIRP/005 Consulting Services for Environmental and Social Audit and Environmental

Management Plan

1,200,000 789,095 -410,905

Consultancy for Project Supervision

EPIRP/001 Implementing Entity Services

1,500,000 1,826,964.65 326,964.65 Consultancy for Project Accounts

Audit

EPIRP/006 Consultant’s Services for External Project

Audit 70,000 58,899 -11,111

Environmental Monitoring and Capacity Building1

EPIRP/007 Environmental Monitoring and Capacity

Building 2,400,000 2,400,000 0

Total 35,000,000 39,608,482.42 4,608,482.42

(17)

ANNEX II – Project Implementation Schedule

ZIMFUND: EMERGENCY POWER INFRASTRUCTURE REHABILITATION PROJECT SCHEDULE STATUS AND PROJECTION WORK SCHEDULE

KEY Original Schedule Projection Reporting time original completion projected completion Current Schedule

SR. NO.

1 EPIRP 002 - Rehab. of Ash Plant

2 EPIRP 003 - Rehab. Sub transm ission

3 EPIRP 004 - Rehab. Of distribution sys.

4EPIRP 005 - Env. and Social Audit

5EPIRP 006 - Project Audit

Jul-12 Aug-12 Sep-12 Oct-12 Nov-12 Dec-12 Jan-13 Feb-13 Mar-13 Apr-13 May-13 Jun-13 Jul-13 Apr-12 May-12 Jun-12

Inception, scoping, pre-Qualification Process Contract Aw ard

Preparation of Contract Documents Inception, Technical assessment, Scoping, Pre-Qualification Process Bidding Documents Floatation Evaluation Jan-12 Bidding Documents Evaluation Evaluation

Preparation of Contract Documents Contract Aw ard

Inception, Scoping, Pre-Qualification Process Bidding Documents Floatation Bidding Documents Floatation Works Implementation Works Implementation

Preparation of Contract Documents Contract Aw ard

1.5

Inception, Scoping, Pre-Qualification Process 1.7 Works Implementation 2.7 2.5 3.2 3.3 2.6 3.1 Floatation Aug-13

5.1 Inception, Scoping, Pre-Qualification Process 4.3 4.4 4.5 4.6 3.4 3.5 3.6 4.1 4.2 3.7 1.6 2.1 2.2 2.3 2.4 1.1 1.2 1.3 1.4

Sep-13 Oct-13 Nov-13 Dec-13

5.7 Implementation 5.4 Evaluation

5.5 Preparation of Contract Documents 5.6 Contract Aw ard

4.7 Implementation

Preparation of Contract Documents Contract Aw ard Floatation Evaluation 5.2 Bidding Documents 5.3 Projected completion by Jan 2014 Projected completion by Apr 2014 Projected completion by July 2014 Projected completion by May 2014 Projected completion by Dec 2014

Figure

Table 1: Original Project Cost Estimates by Component
Table 3 – Comparison between cost estimates and contract prices
Table 4: Supplementary Financing Categories of Expenditure

References

Related documents

(In the example, there is trade if and only if Peter’s valuation exceeds Erika’s valuation by 1/4.) The double auction described above is formally identical with a direct

Every quarter, we will produce Business Reviews which are reported to Management Team and councillors via Executive Committee (WDDC) or Management Committee and Scrutiny

Child  protection:   LSS  provides  legal  representation  to  financially  eligible  clients  who  have  a  legal   problem  under  the   Child,  Family  and  Community  Service

4 shirt clip holds cable in place slide the cable cinch up cable cinch.. PUTTING ON THE EARPHONES

Adjust the connected televisions input setting to match the input used in the previous step.. Coaxial Digital

Partners are external actors or organizations (public or private) that are not included in the value chain’s core stages but occupy a critical role in the functioning of the business
